PMI Scheduling Professional (PMI-SP) — Free Practice Questions
10 free sample questions from a bank of 70, with the correct answers and explanations. No signup required — start practising right now.
1Once the project's WBS has been created what process may happen next?
Estimate activity resources
Define activities
Estimate activity durations
Sequence activities
Answer: B
The short version
B — Define Activities is next after the WBS is created and approved.
Key concepts
Create WBS produces work packages.
Define Activities decomposes work packages into schedule activities via decomposition, rolling-wave planning, templates, expert judgment.
Estimate resources/durations and Sequence Activities all require the activity list first.
Why B is correct
Once the WBS defines _what_ work is in scope, Define Activities defines the _actions_ needed to produce each work package (e.g., Build Foundation → excavate, lay rebar, pour, cure). PMI-SP sequencing logic requires the activity list before any resourcing, estimating, or networking.
Why the others are wrong
A — Estimate activity resources: needs activity list and attributes to know what resources each activity needs.
D — Sequence activities: cannot build PDM network without activities as nodes.
PMI-SP exam tip
WBS → Define Activities → Sequence → Estimate Resources → Estimate Durations → Develop Schedule. If a choice assumes the activity list exists, it comes after Define Activities.
2You are the project manager of the NHQ Project. Management has set a conformance to the project schedule for your project at 0.95. What does this term mean?
It means the largest schedule variance you can have is five percent.
It is the earned value divided by the planned value for your project.
It is the expectation of management to be 95 on schedule at 95 percent of the project.
It means you will need to earn at least 95 cents per dollar invested in the project.
Answer: A
The short version
A — largest schedule variance is five percent. Conformance 0.95 = stay within 5% of plan.
Key concepts
Conformance to schedule = required adherence / tolerance.
1.00 = perfect; 0.95 = allow 0.05 deviation.
Distinct from SPI (EV/PV) and CPI (EV/AC).
Why A is correct
Management set tolerance: do not let schedule slip more than 1 − 0.95 = 5%. Report variance against that threshold; breach requires corrective action.
Why the others are wrong
B — EV/PV: that defines Schedule Performance Index (SPI), not conformance.
C — 95 on schedule at 95%: garbled wording, not a PMI metric.
D — 95 cents per dollar: that describes Cost Performance Index (CPI = EV/AC), not schedule conformance.
PMI-SP exam tip
Conformance = tolerance. SPI/CPI = ratios. SV/CV = dollar/day variances. Read whether the stem asks for tolerance, ratio, or variance.

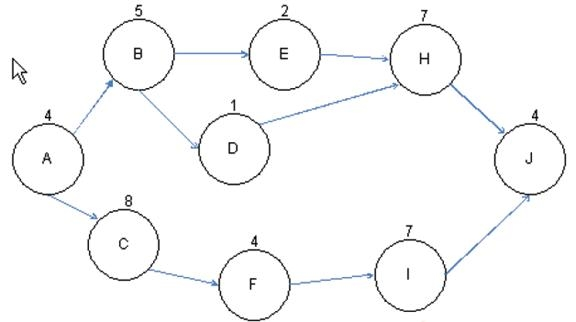

3You are the project manager of the NHQ Project. You have created the project network diagram as shown in the figure: Based on the project network diagram, how much float is available for Activity H if Activity B is delayed by four days and Activity D is delayed by two days?
One
Five
Four
Zero
Answer: D
The short version
D - Zero float remains for H.
Key concepts in this question
Total float, critical path, path duration vs project duration.
Why D is correct
Path ABDHJ was 21 days with 27-day limit. Added 4+2=6 days makes it 27 days, consuming all float. H has no remaining float.
Why the others are wrong
A/B/C (One/Five/Four) all assume float remains, but 21+6=27 leaves zero slack without delaying project.
PMI-SP exam tip
Float = Late dates minus Early dates; when consumed duration equals project duration, float is zero.
4You are working as a project manager for BlueWell Inc. Which of the following tools and techniques of the Define Activity process will help you in identifying the typical schedule milestones?
Expert Judgment
Decomposition
Rolling Wave Planning
Templates
Answer: D
The short version
D - Templates.
Key concepts in this question
Define Activities, templates from prior projects, standard milestones.
Why D is correct
Templates from previous project activity lists carry typical milestones and help define new activities faster.
Why the others are wrong
A Expert Judgment provides advice but not standard milestone list; B Decomposition breaks WBS into activities; C Rolling Wave plans near-term detail only.
PMI-SP exam tip
When question asks for typical/standard/repeatable list from past projects, think Templates.

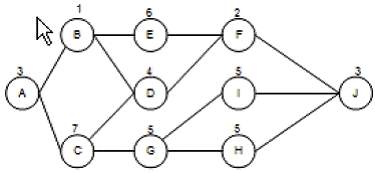

5You are the project manager of the NHG. The following figure represents your project network diagram. Management has asked that you add some features to the project scope. Through the change control system these changes are approved and they'll affect
Activity I. The duration of Activity I, which is on the critical path, will decrease by three days. What affect does this have on the critical path?
Paths ACGIJ and ACGHJ both 23 days. I shortens 3 days so ACGIJ becomes 20 days, but ACGHJ stays 23 days and remains critical.
Why the others are wrong
A 26 days wrong direction; B 17 days and D 20 days confuse reduced path ACGIJ with overall critical path.
PMI-SP exam tip
Shortening one critical path does not shorten project if another critical path remains.
6You are the project manager of the NHA Project. This project is expected to last one year with quarterly milestones throughout the year. Your project is supposed to be at the third milestone today but you're likely only 60 percent complete. Your project has a BAC of $745,000 and you've spent $440,000 of the budget-to-date.
What is your schedule performance index for this project?
A 80 missing decimal; B 1.02 is CPI-like >1; C 102 invalid scaling.
PMI-SP exam tip
SPI uses PV at planned percent, not AC; <1 means behind schedule.
7Which of the following scheduling techniques identifies the successor activities and the predecessor activities to assist the project manager in sequencing the project work?
Precedence Diagramming Method
Schedule network template
Dependency determination
Activity on the Node
Answer: A
The short version
A — Precedence Diagramming Method (PDM) identifies predecessors and successors for sequencing.
PDM explicitly maps each activity's predecessors (incoming) and successors (outgoing) to build the network diagram. It is the most common network technique on PMI-SP questions.
Why the others are wrong
B — Schedule network template: accelerates networking by copying a prior project, does not itself define logic.
C — Dependency determination: decides _type/order rationale_, not the diagram technique.
D — Activity on the Node: AON is a PDM representation (activities on circles), i.e., a subset/example of A, not the best answer to "which technique identifies predecessors/successors."
PMI-SP exam tip
If the stem says predecessors + successors + network, pick PDM. If it says copy prior project, pick template.
8Gina is the project manager for her organization and she is working with her project team to define the project activities. In this project, the stakeholders are sensitive to the project completion date, so Gina is stressing to her project team members that while they need to provide and account for all of the project activities, they should focus on one work package in the WBS at a time. In order to start the decomposition of the project work packages into activities, Gina will need all of the following except for which one?
Scope baseline (which contains WBS + scope statement + WBS dictionary) is the listed input, not standalone WBS.
Why the others are wrong
A Scope baseline, B OPA, D EEF are all formal inputs to Define Activities.
PMI-SP exam tip
If scope baseline is an input, standalone WBS is not separately listed - watch except questions.
9You have created the project network diagram for the ABC project. You are exploring total float and free float for that project. Martin, a project team member, wants to know the difference between total float and free float. What is the difference between total float and free float?
Total float is the amount of time an activity can be delayed without delaying any project successors, whereas free float is the amount of time an activity can be delayed without delaying the project completion date.
Total float is the amount of time an activity can be delayed without delaying the project completion date, whereas free float is the amount of time an activity can be delayed without delaying any project successors.
Total float is the amount of time an activity can be delayed without delaying the project completion date, whereas free float is the amount of time an activity can be delayed without delaying any project predecessors.
Total float is the amount of time a non-critical activity can be delayed without delaying any project successors, whereas free float is the amount of time an
Answer: B
The short version
B - Total vs free float definitions.
Key concepts in this question
Total float protects project finish; free float protects successors ES.
Why B is correct
Total float delays without delaying project completion; free float delays without delaying any successor early start.
Why the others are wrong
A swaps definitions; C wrongly says predecessors instead of successors; D is truncated and mixes non-critical wording.
PMI-SP exam tip
Free = successors; Total = project finish.
10Your project has a BAC of $750,000 and is 75 percent complete. According to your plan, however, your project should actually be 80 percent complete. You have spent $575,000 of your project budget to reach this point and you are worried about the project not being able to complete based on your current project budget.
What is the to-complete performance index for this project?
0.98
-$16,677
1.07
0.94
Answer: C
The short version
C - TCPI 1.07.
Key concepts in this question
TCPI=(BAC-EV)/(BAC-AC) to meet BAC.
Why C is correct
EV=0.75x750000=562500. (750000-562500)/(750000-575000)=187500/175000=1.07, harder than 1 so BAC at risk.
Why the others are wrong
A 0.98 is CPI; B -$16667 is VAC-style; D 0.94 is SPI.
PMI-SP exam tip
TCPI>1 means must be more efficient than before to meet BAC.
